A project that was meant to finish in October is still running in February, the crew has been stood down twice, and the other party has started talking about liquidated damages. Nobody agrees whose fault it is, and the contract has a notice clause you cannot remember reading. This is the point where a delay and disruption claim lawyer earns their fee.

A delay and disruption claim lawyer helps you prove that an event pushed back your completion date (delay) or made your work less efficient (disruption), serve extension of time notices before contractual time bars expire, and recover costs through the contract or a Security of Payment Act adjudication. Strong site records and critical path analysis decide most claims.

This guide follows the order a claimant actually works through: classify the claim, protect your time, understand your exposure to damages, prove the loss, and recover the money.

What is the difference between a delay claim and a disruption claim?

A delay claim concerns time: an event pushed back the date for completion. A disruption claim concerns efficiency: an event made the work harder, slower or more costly to carry out, even if the completion date did not move. The two are often run together, but they are proved differently and they recover different things.

Delay: the critical path

Delay is measured against the critical path, the longest chain of linked activities that sets the completion date. If a late design change holds up a task with weeks of float, the project may still finish on time, so there is no delay to completion. If the same change holds up a task on the critical path, every day lost there adds a day to the end date.

In practice, this is why a delay claim is not a list of bad days on site. You must show that the specific event delayed the activities that controlled completion, not just that work stopped for a while.

Disruption: lost efficiency

Disruption is the loss of productivity. Examples include out-of-sequence work forced on a subcontractor, repeated stop-start mobilisations, congested access, trades stacking on one another, or a crew that planned one clean run through a floor and had to return three times. The completion date may be untouched, but the labour and plant hours spent were higher than priced.

A disruption claim is a claim for cost, not for time. It is usually harder to prove, because the loss is the gap between what the work should have taken and what it did take.

Excusable versus compensable delay

Not every delay entitles you to money. Contracts and practitioners generally sort delay into three groups:

  • Non-excusable delay: caused by the contractor, such as late ordering, poor resourcing or rework. No extra time and no extra money.
  • Excusable but non-compensable delay: caused by events neither party controls, such as extreme weather or certain industry-wide shortages. The contractor may be entitled to more time, but not to delay costs.
  • Excusable and compensable delay: caused by the principal or the principal's side, such as late site access, late information or instructed variations. The contractor may be entitled to both more time and the costs of the delay.

Which group an event falls into depends on the wording of your contract. A lawyer reads those clauses; a consultant then tests the facts against them. Classify your own claim first, because that decides what you notify, what you prove, and what you can ask for.

Extension of time notices and time bars: how to protect your claim

An extension of time (EOT) notice is the formal written step that preserves your right to more time, and often your right to delay costs. Many construction contracts in NSW require notice within a fixed period of the delaying event, and a missed deadline can bar the claim, whatever its merit. This is the most common way a sound claim is lost.

Step 1: Identify a qualifying cause for an EOT

Start with the contract, not the programme. Look for the clause that lists the events entitling you to more time. Typical causes include variations directed by the principal, late provision of information or access, suspension, and defined weather or industry events.

Match the real event to the listed cause. A vague complaint that "the job ran late" does not qualify; "the architect's revised drawings were issued 19 days after the date in the information schedule" does. If the event is not a listed cause, you may have no EOT entitlement under the contract, however frustrating the delay.

Step 2: Serve notice within the contractual time bar

Check three things in the notice clause: who must give notice, in what form, and by when. Some contracts require a short initial notice soon after the event, followed by a detailed claim later. Others tie the deadline to when you became aware, or ought to have become aware, of the delay.

Practical points that cause trouble:

  • Serve notice in the manner the contract prescribes (to the right person, at the right address or system).
  • Keep proof of service.
  • Notify each delaying event separately where the contract requires it, rather than bundling them.
  • Do not assume the other party's knowledge of the event replaces formal notice.

Day-counting definitions also matter. Whether a deadline runs in calendar days, business days or working days can change the last date for service, and the rules around them have been under review. Check the definitions in your contract and in the current legislation rather than relying on an old template.

Step 3: Separate time from money

An EOT protects you against being late. It does not, on its own, pay you for the cost of being delayed. Many contracts treat a claim for time and a claim for delay costs as separate entitlements, each with its own notice and substantiation requirements.

An EOT may relieve you of liquidated damages exposure, but a cost claim still has to be notified, quantified and proved. A contractor who gets the time and forgets to claim the costs in the required form often finds the money is gone.

Step 4: Keep a diary from day one

Notice is only as strong as the record behind it. Log the event, the date you knew of it, and its effect on the work as it happens. If the dispute reaches NCAT or a court, a lawyer will need those entries, and an independent expert will rely on them. The next sections show how that evidence is used.

Are liquidated damages automatic if a project runs late?

No. Liquidated damages are not automatic simply because a project finished after the date for completion. They are a pre-agreed sum, usually a daily rate, payable only where the contract provides for them and only if the conditions for claiming them are met.

How liquidated damages work

The contract sets a date for practical completion and a daily rate for each day beyond it. The principal can then deduct or claim that rate instead of proving actual loss. The appeal for both sides is certainty, because the amount is fixed in advance.

That certainty has limits. The date for completion is not fixed if the contractor is entitled to extensions. Liquidated damages run only from the date for completion as properly adjusted by any EOT. So a late finish is only the start of the question; the real issue is whether the contractor was entitled to more time.

The prevention principle in general terms

Courts have long applied what is called the prevention principle: a party generally cannot rely on a time requirement where its own conduct stopped the other party from meeting it. If the principal caused delay, for example by issuing late instructions or failing to give access, and the contract has no workable way to extend time for that cause, the date for completion can fall away. Liquidated damages may then become difficult or impossible to enforce.

This is why a contract's EOT mechanism matters so much. A working process lets the principal's delay be recognised and the date adjusted. A broken one can undermine the right to damages altogether.

Where a defective EOT process bites

Problems tend to arise in a few places:

  • The principal ignores or fails to assess a valid EOT notice within the time the contract allows.
  • The contract says the principal need not extend time for its own delay, or limits the cause of extension too narrowly.
  • The contractor serves notice late and the contract says late notice defeats the entitlement.

How these clash depends on the exact drafting and the facts, and the case law is detailed. A construction lawyer applies it to your contract. Nothing here replaces that advice, and you should not assume a general rule applies to your project. If you face a liquidated damages demand, put the EOT history and the contract in front of a lawyer before you respond in writing.

How to prove delay and disruption: site documentation and critical path analysis

You prove a delay claim by showing that a specific event delayed the activities controlling completion, and a disruption claim by showing, through contemporaneous records, that the work took more labour or plant than it should have. Both depend on evidence created at the time, not reconstructed afterwards.

Evidence for a delay claim

A delay claim needs a programme that people can test. Gather the following:

  • The baseline programme: the agreed or accepted programme at the start, showing the planned critical path and the float on other activities.
  • Updated programmes: each revision, with the date it was issued and who accepted it. A programme updated monthly lets an analyst see how the critical path moved.
  • Notices and responses: every EOT notice, instruction, direction and reply, with proof of service.
  • Site diaries and daily reports: weather, labour on site, plant, deliveries, visitors, and what stopped work and why.
  • Progress photographs and video: dated images of the work at the time of the event.
  • Correspondence and meeting minutes: requests for information, drawing issue registers and the dates information actually arrived against the dates it was due.

The programme evidence gives a critical path analysis something to work from. That analysis, usually prepared by a scheduling specialist, tests whether the event sat on the critical path and how many days it moved the completion date. A claim that cannot link the event to the end date tends to fail on causation, however many bad days are recorded.

Evidence for a disruption claim

Disruption is a comparison, so you need two sets of figures: what the work should have taken, and what it did take. Useful records include:

  • The tender allowances: your estimate of labour hours, plant and productivity rates for the work as priced.
  • Timesheets and plant logs: actual hours by task, area and date.
  • Records of resequencing: evidence that work was forced out of order, interrupted or returned to, such as revised instructions and area handover dates.
  • Evidence of congestion or interference: photographs and diary entries showing other trades occupying your work area.
  • Comparison periods: productivity on an unaffected part of the project, used as a yardstick for the affected part.

The more closely a record is tied to the date and the event, the more weight it carries. A summary written months later from memory is a poor substitute for a daily entry made the same afternoon.

What to do when the critical path impact is unclear

Many subcontractors work without a programme they trust, or find that the principal's programme was never properly updated. A disruption claim can still be put on the basis of lost efficiency without proving that completion moved. You do not need to show a delay to the end date to claim the cost of working less efficiently, provided your contract does not exclude it.

In practice, approaches include a measured-mile comparison between affected and unaffected work, an as-planned versus as-built comparison of resources, and a detailed review of the records showing why the work could not proceed as intended. Each method has limits, and you should expect the other side to attack the baseline. Where the programme is weak, the contemporaneous records become the main evidence, which is another reason to keep them from day one.

Be realistic about overlap. If delay and disruption arise from the same event, you cannot recover the same cost twice. Claims that count the same lost hours under both heads invite a challenge.

Where an independent expert fits

A building consultant can inspect the work, assess what was done and when, and set out the findings in a form suitable for NCAT or a court. Awesim Building Consultants is a building consultancy that prepares independent Expert Witness Reports and related evidence for homeowners, builders, solicitors and strata managers in NSW. A lawyer decides how the evidence is used; the consultant gives the tribunal an impartial technical account that can withstand scrutiny.

Recovering delay costs under the Security of Payment Act

The Security of Payment Act is a fast route for recovering delay and variation costs on a construction contract, because it lets you serve a payment claim and, if the payer does not respond properly, have the claim decided by an adjudicator rather than waiting for a full court hearing. It is a payment mechanism, not a substitute for proving your entitlement.

Delay costs can only be recovered this way if they form part of what is claimed under the contract. The adjudicator decides the amount payable on the material before them, so the quality of your claim and supporting documents decides the result. NSW adjudication data shows why the process matters.

According to mondaq.com, the average value of construction claims in NSW during 2025 was $569,000. Reporting on NSW Security of Payment data from early 2026, mondaq.com notes that 50% of claimants were awarded their full claimed amount. The message is plain: claims are often large, some succeed in full, and many do not. Preparation separates them.

Step 1: Establish what the contract allows you to claim

Before serving anything, confirm that the delay cost sits within a contractual entitlement: an accepted or deemed EOT, a compensable delay event, or a variation that carries time costs. A claim for costs the contract does not allow, or for delay never notified, will struggle at adjudication.

This is also where a specialist lawyer earns their fee. Practices such as Contracts Specialist offer legal services to NSW homeowners and contractors, including contract review and Security of Payment debt recovery. Whoever you engage, ask how they will connect the delay costs to a specific clause.

Step 2: Serve a valid payment claim

A payment claim must meet the Act's requirements, which include being in writing, identifying the work or the goods and services, stating the amount claimed, and being served within the time allowed. A defective claim can be set aside, so the form matters as much as the content. Our guide to Security of Payment NSW: claims and schedules explains the mechanics for builders in more detail.

Step 3: Watch the response deadlines

After service, the respondent has a limited time to provide a payment schedule setting out what it will pay and why it withholds the rest. If it fails to do so, the claimant may have strong rights to proceed. If it does respond, the reasons it gives will generally define what it can argue at adjudication, so read the schedule closely.

Step 4: Apply for adjudication with strong supporting material

Where the amount is disputed or unpaid, an adjudication application puts the claim before an authorised adjudicator who decides on the documents. Attach the evidence covered in the previous section: notices, programmes, diaries, records and cost build-ups. An adjudicator has a short window and cannot test a poorly documented claim, so a clear, well-indexed submission matters.

Variations and the risk of delay

Delay and variation disputes often travel together, and the stakes are not only financial. An analysis of NSW Security of Payment Act cases by Contracts Specialist found that 10.2% of variation-related disputes resulted in project termination or abandonment. That figure is vendor-reported and concerns variation disputes, not delay claims, so read it as a sign of how badly an unresolved payment dispute can end, not as a delay statistic. It is still a good reason to raise and resolve entitlement early.

Limits of the process

Adjudication is quick and can be rough. It produces a determination of what is payable on the material before the adjudicator, and the underlying dispute can still be pursued in another forum. A claimant who treats it as a last-minute tactic, without the records to support it, is unlikely to do well.

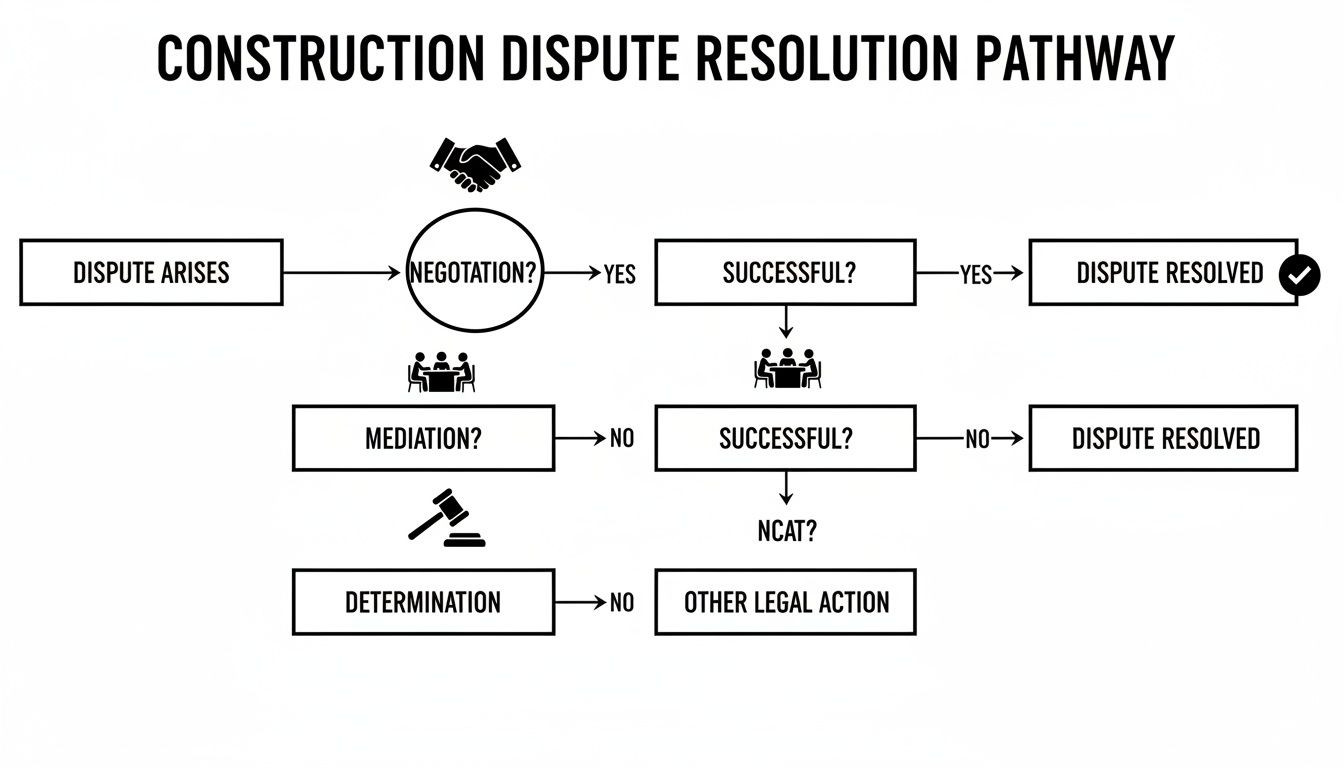

Which pathway fits your delay claim: NCAT, SOPA adjudication or the courts?

The right pathway depends mainly on who the parties are and how large and complex the claim is. A smaller residential dispute with a homeowner usually runs through Fair Trading, mediation and then NCAT. A payment claim for progress or delay costs on a contract often suits Security of Payment adjudication. Large or complex commercial claims end up in the District or Supreme Court.

Disputes are not rare. Accura Consulting reports that Australian construction projects experience a higher dispute frequency than the UAE or Saudi Arabia, with 30 disputes occurring for every 100 projects. It also reports a litigation rate of 55% for construction disputes in Australia as of 2024. Whether or not a given project reaches court, the numbers explain why a claimant should plan the pathway and the evidence early rather than hope the other side relents.

The table below sets out the three main routes and who they best suit.

Typical claimWhere it is usually decidedFormalityBest suited to
Smaller residential delay or defect dispute: Fair Trading, mediation, then NCATNSW Fair Trading, mediation, then NCATLow to mediumHomeowners and builders in residential building disputes
Progress or delay cost payment claim on a contractSOPA adjudicationMedium (document-based, fast)Contractors and subcontractors chasing unpaid sums
Large or complex commercial claimNSW District or Supreme CourtHighHigh-value or legally complex commercial disputes

Residential delay claims

Residential disputes tend to start with a conversation, then mediation, then a formal application. For many homeowners and small builders, the tribunal is designed to be more accessible than a court, and parties often rely on an inspection report and a Scott Schedule to set out the contested items. If your dispute includes both delay and defects, the same expert can address both in one body of evidence. A Scott Schedule is a table that lists each disputed item, with each party's position and the expert's comment beside it, so the tribunal can work through them one by one.

Commercial payment claims

For commercial contractors and subcontractors, adjudication under the Security of Payment Act is often the first formal step, because it is quicker than a full hearing and focuses on payment. Large claims with contested contract interpretation, big sums or multiple parties often progress to the courts, where the process is slower, more formal and more expensive.

A note on day-counting

Notice periods and response deadlines depend on how days are counted. Whether a period runs in calendar days, business days or working days changes the last date for service, and the definitions have been the subject of legislative change. Do not rely on an older template or a guess. Check the day-counting definitions in your contract and in the current legislation before calculating any deadline, and have your lawyer confirm the dates in writing.

Choosing in practice

Match the pathway to the claim, not the other way round. Ask whether the claim is mainly about money owed or about the quality and timing of the work, whether the other party is a homeowner or a commercial principal, and how much evidence you already hold. Then plan the technical evidence to suit the forum, because the tribunal or adjudicator will only be able to act on what is put in front of them.

Construction claims in NSW: what they involve and what they cost

Construction claims in NSW are formal demands for money, time or rectification that arise when a contract does not run as planned. They cover unpaid progress payments, variations, delay and disruption costs, and defective or incomplete work. Most start as a disagreement on site and become a claim once notices are served and sums are put in writing.

The main types you will meet are:

  • Payment claims: a demand for the contract sum or progress payment, often made under the Security of Payment Act.
  • Variation claims: a claim for work outside the original scope that was instructed, or that the claimant says was.
  • Delay and disruption claims: a claim for extra time, extra cost, or both, as covered above.
  • Defect claims: a claim that completed work does not meet the contract, the National Construction Code or the relevant Australian Standard.

Disputes are common enough to plan for. A report from Accura Consulting puts Australian construction at 30 disputes for every 100 projects. Size matters too: the average claim is large enough that careful preparation pays for itself.

Cost comes from more than the final invoice. Legal fees, expert reports, filing fees and the time your own team spends gathering records all add up, and an unresolved claim can hold up the next job. A lawyer can give you a realistic estimate for your matter. Spending on strong evidence early tends to cost less than a long argument over what the facts were. For a clearer view of how the roles divide at each stage, see Building Dispute Lawyer vs Building Consultant: who you need at each stage of a NSW claim.

How a delay and disruption claim lawyer and building expert work together

A delay and disruption claim lawyer and an independent building consultant do different jobs on the same matter. The lawyer handles the contract: reading the notice clauses, serving EOT notices and payment claims on time, advising on liquidated damages exposure and choosing the forum. The consultant handles the facts on site: inspecting the work, testing what was done and when, and putting the findings in a report that a tribunal or adjudicator can rely on.

Awesim Building Consultants is a building consultancy operating across NSW since 1996. It prepares independent Expert Witness Reports, Scott Schedules and Quantum Meruit Reports for use in NCAT, the NSW District Court and the Supreme Court, and serves homeowners, builders, solicitors and strata managers. Awesim provides expert evidence, not legal advice, and it does not issue EOT notices or run payment claims. Those steps stay with your lawyer.

In practice, the two work in sequence. The lawyer identifies the issues in dispute and instructs the expert. The consultant inspects, records the condition and progress of the work, and sets out the findings and costings. Where a claim involves both delay and defects, one body of evidence can cover both. Waterproofing is a common example: a failed membrane often forces rework that delays later trades, and how inspectors find the cause of waterproof membrane failure shows the kind of technical findings that link a defect to lost time.

For more on the evidence itself, see Awesim's pages on construction claims experts and witness reports and building inspection reports and expert evidence. To help you choose a lawyer, ask:

  • How many delay or payment disputes have you run in the last 12 months?
  • How will you connect my delay costs to a specific contract clause?
  • Which notices must be served now, and by what date?
  • When would you recommend instructing an independent expert, and what should that expert be asked?
  • What is your estimate of total cost, including expert and filing fees?

FAQs

Are liquidated damages automatic if a project is late?

No. Liquidated damages are a pre-agreed daily sum, payable only if the contract provides for them and the conditions are met. They run from the date for completion as adjusted by any valid extension of time. If the principal caused delay and the contract has no workable way to extend time, the date can fall away, and the right to damages may be lost. A lawyer should review the EOT history before you respond to any demand.

What is the difference between an excusable and a compensable delay in NSW?

An excusable delay is one the contract treats as grounds for more time, such as a principal's late instruction or defined weather. A compensable delay is an excusable one that also entitles you to delay costs, usually because the principal's side caused it. Some delays earn time but no money. Which category applies depends on the wording of your contract, so check the clause before you claim.

Can I lose my right to a delay claim if I miss the notice deadline?

Yes. Many NSW construction contracts set a time bar, and a late or incorrectly served notice can defeat the claim even when the delay was real. Check who must give notice, in what form and by when, and keep proof of service. Day-counting rules also affect the last date, so confirm them against the contract and current legislation, and have your lawyer verify the date.

How do I prove a disruption claim without a clear critical path impact?

You can claim the cost of lost efficiency without showing that completion moved, provided your contract does not exclude it. Use contemporaneous records: tender allowances, timesheets, plant logs, diaries and photographs. Compare productivity in affected and unaffected areas, and show how the work was forced out of sequence. Expect the other side to challenge your baseline, so keep records dated and tied to specific events.

Can I represent myself at NCAT for a residential delay dispute?

You can. NCAT is designed to be more accessible than a court, and many parties handle smaller matters without a lawyer. The risk is that you carry the burden of knowing the contract terms, the notice requirements and the evidence rules. If the dispute involves several items, a significant sum or complex contract clauses, legal advice and an independent expert report are worth the cost.

How long do construction disputes usually take to resolve?

It depends on the pathway and the complexity. A matter settled by negotiation or mediation can close in weeks or a few months, while a contested hearing at NCAT or a court takes considerably longer. Strong evidence at the start tends to shorten the process, because it gives the other side a clear reason to settle. Ask your lawyer for an estimate based on your forum.

What should I do first when a delay dispute looks likely?

Document everything and check your notice obligations. Gather the contract, programmes, correspondence, diaries and photographs, and identify any deadline for an EOT notice or payment claim. Put your concerns to the other party in writing. Then speak to a construction lawyer about the contract and, where the facts are technical, an independent building consultant about inspection-based evidence.

Conclusion

A delay and disruption claim is won on three things: notices served within the contractual time bar, records made at the time, and an analysis that links the event to the lost time or lost efficiency. The right forum then depends on whether the dispute is residential or commercial, and on how much is at stake.

Start by reading the notice clause in your contract and listing the deadlines still open to you. Then collect your programmes, diaries and correspondence into one file, and take it to a construction lawyer before you respond in writing to any demand.

author avatar
Glen Sim Managing Director
Glen Sim is the Founder and Director of Awesim Building Consultants. He is a qualified carpenter, licensed builder and building expert witness with more than 35 years of construction experience. Based in New South Wales, he provides building consultancy, expert witness reports, Scott Schedules and building defect inspections across Australia, including support for NCAT building disputes in NSW.
